MegaKim World Corp (Time Square)

Status Active Founded 2011 HQ Phnom Penh Markets Phnom Penh · Sihanoukville Completed 4 projects
Qualified Reviewed
The desk verdict

Repeat builder: four towers completed 2017–2025, three through the post-2019 slump. Held at 65 on the Oct 2026 review: the live pipeline is smaller than we said, but its own pages conflict on heights, dates and project counts, and on-time claims are unaudited.

Developer of Phnom Penh's Time Square condo series: four towers completed in BKK1 and Toul Kork from 2017 to 2025, four under construction (including a 50-storey Russian Market tower and an Otres Beach project) and two that broke ground in June 2026.

Trust score 65/100
Founded2011
Head officePhnom Penh
Projects completed 4
Under construction 4
Condominium

Both sides, plainly

We name the downside as clearly as the upside.

Why we rate it
  • Real, repeated delivery: Time Square 1 (17 storeys, 2017), 2 (30 storeys, 2021), 3 (25 storeys, 2023) and 5 (2025; height disputed, 45 or 27 storeys) are completed towers, three of them delivered through the COVID and post-boom years that stalled many competitors. IPS put TS1 and TS3 at about 85% occupancy in 2025.
  • Fifteen years in the market (since 2011) under one brand, longer than most of the condo cohort.
  • Established Phnom Penh condo districts: BKK1, Toul Kork and the Russian Market area.
  • Buyer mix: the developer says about half its buyers are Cambodian, the rest from China, Japan, South Korea, Russia and Europe. That is its own statement, but if accurate the book depends less on foreign pre-sales than the pricing suggests.
Watch items
  • Pipeline concentration: four towers under construction (TS6, 7, 8 and 10), with TS6 near completion according to sales agent IPS, plus TS9 and TS11, which broke ground in June 2026 with construction scheduled for later in 2026. That is far more simultaneous pre-sale exposure than the completed record was built on.
  • Scale escalation: the completed towers run 17–30 storeys, plus TS5, which is 45 storeys on the developer's homepage and at IPS but 27 on its own project page, so the tallest delivered height is disputed. TS7 and TS8 are listed at 49–50 storeys and TS6 at 48–49. Each generation is a bigger bet than the record proves.
  • Investor-grade product: ERA lists TS8 one-bedrooms at $39,900–$64,000, marketed on rental yield. The developer says about half its buyers are Cambodian and the rest foreign; investor demand is the first to thin in a downturn, a resale and developer-cashflow risk.
  • Inconsistent self-published specs: the developer's pages give TS5 as 45 or 27 storeys and TS6 as 48 or 28 storeys, TS6 completion as 2028 (homepage) against IPS's 2027 handover, and the track record as four, five, seven or "10 successful projects". Get the specification into the sale contract.
  • The Sihanoukville entry (TS10, Otres) takes a Phnom Penh-proven formula into the market with Cambodia's worst completion history.
  • On-time-delivery reputation is self-reported and repeated by agents who sell the units (IPS, ERA); we found no independent audit of handover dates against promises.

The full dossier

MegaKim World Corp is the most prolific pure-condo builder in this directory: a Phnom Penh developer (Cambodia Investment Review calls Time Square “a Cambodian developer” [S-203]) that has worked a single formula — towers in established Phnom Penh districts under the Time Square brand — since 2011 [S-011] [S-077]. The formula has demonstrably worked four times, between 2017 and 2025. The question a buyer must answer is whether it works again across six more towers at different stages, the tallest at 49–50 storeys, in two cities. The developer’s own pages disagree with each other on several heights and dates, so we flag those as disputed below rather than pick one. Citations are marked [S-NNN]; the source list is at the end.

Who they are

MegaKim has developed in Cambodia since 2011 and markets itself on having “earned the trust of thousands of buyers by delivering every project on time and as promised” [S-077]. Agencies repeat the framing — “a strong track record of seven successful projects” [S-078] — and the developer’s homepage now claims “10 successful projects”, while its Time Square 5 page speaks of “four fully sold-out projects” [S-077]. IPS, which sells the projects, says the company has “a very strong track record of completing projects on schedule” [S-204]. We have found no independent audit of promised-versus-actual handover dates, so treat the on-time part as self-reported. At the June 2026 ground-breaking, Vladimir Palancica, representing Time Square, said about half of its buyers are Cambodian, with the rest from China, Japan, South Korea, Russia and Europe [S-203]; that too is the company’s own account. What is independently visible is the buildings themselves.

The delivery record

The completed series, per the developer’s pages and IPS [S-077] [S-204]:

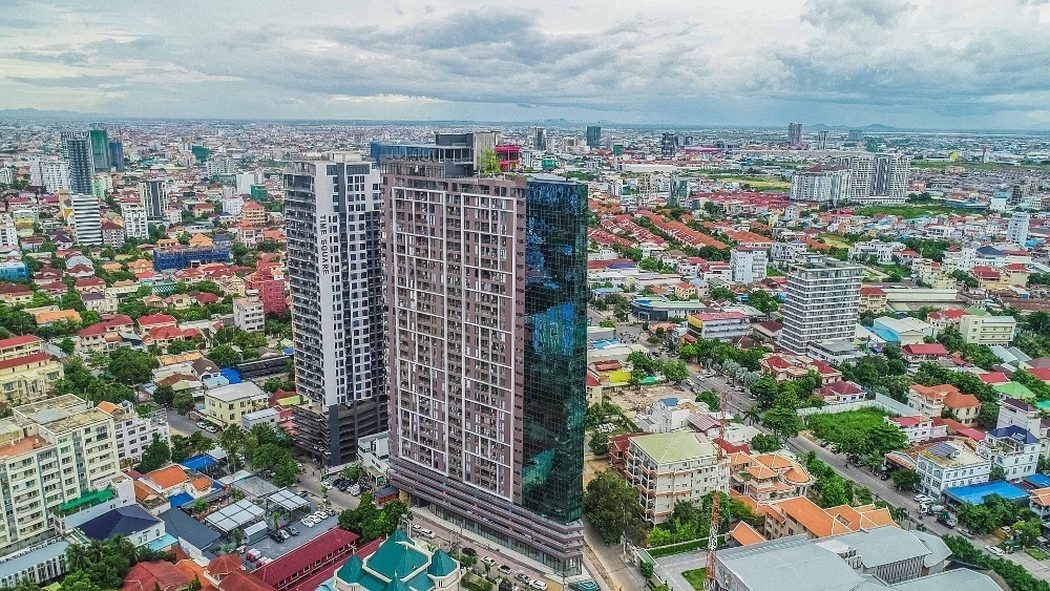

  • Time Square 1 — BKK1, 17 storeys, 78 units, completed 2017.
  • Time Square 2 — Toul Kork, 30 storeys, completed 2021.

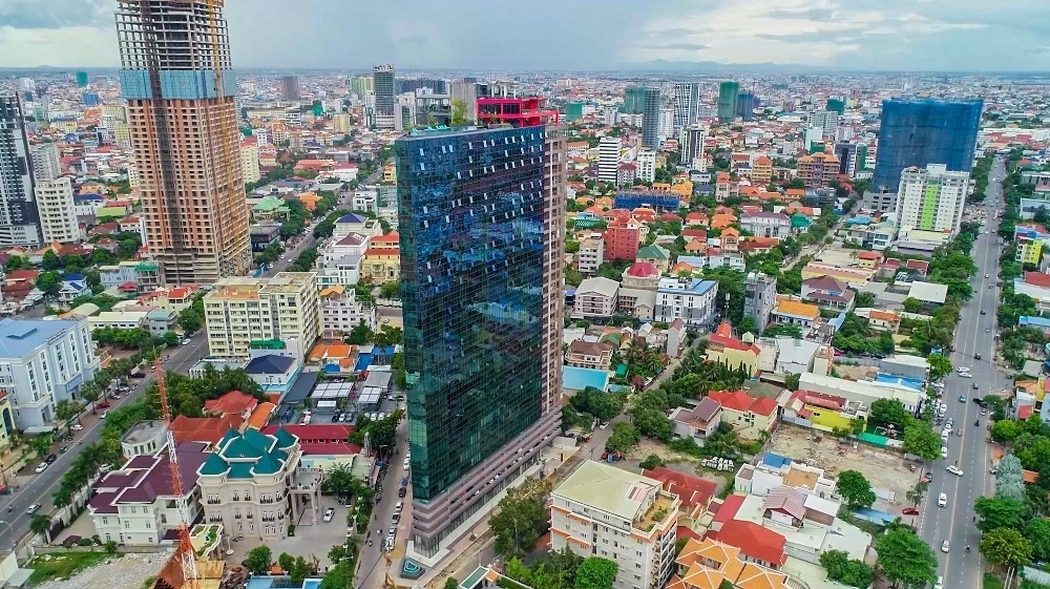

  • Time Square 3 — Toul Kork, 25 storeys, 280 units, completed 2023.

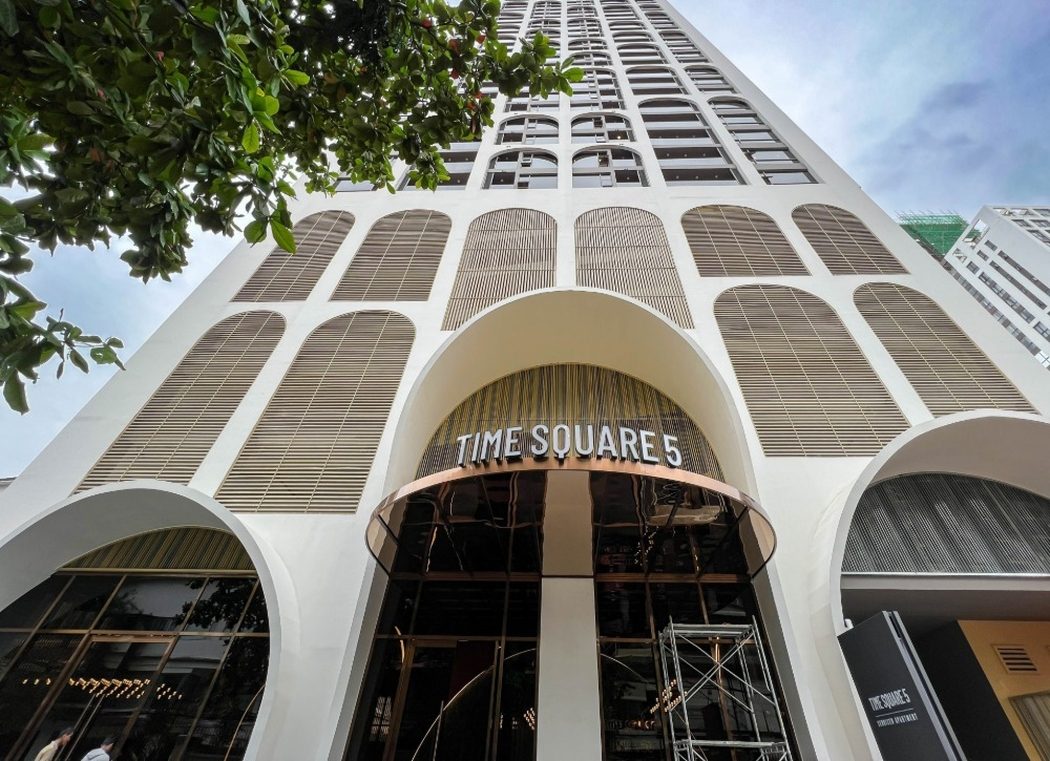

  • Time Square 5 (306) — BKK1, completed 2025. Its height is disputed: the developer’s homepage and IPS give 45 storeys (IPS: 350 units), while the developer’s own project page says 27 storeys and 180 residential units.

Three of those completions landed in the hardest stretch of the modern market — the COVID and post-boom years that stalled hundreds of towers elsewhere. That is the strongest single fact in MegaKim’s favour, and it is not a marketing claim.

The pipeline — where the risk lives

The current book is far bigger than anything the record proves. Most of the progress figures come from IPS, which sells the projects, so read them as a sales source:

  • Time Square 6 (302), BKK1: 48 storeys on the developer’s homepage, 49 floors and 190 metres in IPS’s topping-out report, 28 storeys on its own project page. IPS reported topping out on 10 March 2026, 95% progress and handover in 2027; the developer’s homepage still says 2028 [S-077] [S-204] [S-205].
  • Time Square 7, Toul Kork: 49 storeys, 700 units; 70% in 2026, completion expected 2028 [S-077] [S-204].
  • Time Square 8, Russian Market area: 50 storeys, 700 units; construction launched April 2025, 30% in 2026; ERA states Q4 2028 [S-078] [S-204].
  • Time Square 10, Otres Beach, Sihanoukville: launched 4 December 2025, 15% in 2026 [S-204]; the developer describes three connected towers with 1,300 residential units [S-077].
  • Time Square 9 (The Gatsby Residence, 39 storeys, BKK1) and 11 (The Time Castle, 39 storeys, BKK3) broke ground on 8 June 2026 [S-203]; IPS said construction was scheduled to start in July and September 2026 respectively [S-204], and we have not confirmed that it has.

So the honest count is four towers under construction, one of them nearly finished by IPS’s account, and two more just starting. Three things about it deserve a clear eye:

  • Simultaneity. Several towers in construction at once means pre-sale proceeds across the book are doing the funding work. If sales slow market-wide, every tower competes with its siblings for the cash to finish.
  • Height escalation. The delivered record tops out at either 45 or 27 storeys, depending on which of the developer’s pages you believe; TS6, TS7 and TS8 are listed at 48–50. Taller towers are longer, costlier builds with later break-even — the record is encouraging but not yet proof at this scale.
  • Price point. ERA lists Time Square 8 one-bedrooms from $39,900 to $64,000 [S-078], marketed on rental yield. Even if, as the developer says, half its buyers are Cambodian, investor demand is the first to thin in a downturn, which is precisely when an off-plan buyer needs the developer’s sales to hold up.

The Sihanoukville entry deserves its own sentence: Otres is a new market for MegaKim, carrying the coastal market’s well-documented completion history, and the Phnom Penh record does not transfer to it automatically.

The bottom line

MegaKim is a genuine, repeat-delivery developer — better evidenced than most of the off-plan market, with completions through the cycle’s worst years. The score stops in the mid-60s because the current pipeline is a materially bigger, more simultaneous, more leveraged-to-pre-sales bet than the one the record validates, and because the developer’s own published specifications do not agree with each other. Time Square 6 reaching handover in 2027, as IPS expects, would be the first real test of the larger towers. A buyer in a completed Time Square tower is in a known quantity; a buyer off-plan in the 2028 generation should apply the full off-plan playbook — payment-schedule scrutiny, completion-risk pricing, the specification written into the contract, and no reliance on the on-time slogan — and anyone considering TS10 should read our Sihanoukville research first.

Correction, 25 October 2026: this profile described MegaKim as Taiwanese, which we could not source (CIR calls Time Square a Cambodian developer). It also counted four completions after 2019 (Time Square 1 was completed in 2017), gave Time Square 5’s height inconsistently, stated a 2028 completion for Time Square 6 without IPS’s 2027 handover, and listed six towers under construction (Time Square 9 and 11 had broken ground, with construction scheduled for later in 2026). We corrected unit counts for Time Square 10 and 11 to the developer’s pages, removed unsourced Time Square 11 prices and a “Borey Villa” project we could not find on the developer’s site, and added IPS as a source. The trust score is unchanged at 65.

Sources

Gallery / Visuals

Renders and project imagery from public developer material — credits & takedown policy.

Track record

What was promised, and what was delivered.

2025 Time Square 5 (306) BKK1, Phnom Penh · Condominium · Completed 2025. Height and size are disputed: the developer's homepage and IPS give 45 storeys (IPS: 350 units), while the developer's own project page says 27 storeys, 180 residential units plus commercial space, and "topped out in September 2024". Completed
2023 Time Square 3 Toul Kork, Phnom Penh · Condominium · 280 units · 25 storeys; 280 strata-title residential units plus commercial floors per the official project page; completed 2023 in the Toul Kork cluster alongside TS2. Completed
2021 Time Square 2 Toul Kork, Phnom Penh · Condominium · 30 storeys (unit count not published on the official project page); the project that established the Time Square brand outside BKK1, in the fast-growing Toul Kork district. Completed
2017 Time Square 1 BKK1, Phnom Penh · Condominium · 78 units · 17 storeys and 78 fully furnished units, mostly one-bedrooms; completed 2017 per the developer's project page and IPS. The original of the series. Completed
— Time Square 6 (302) BKK1, Phnom Penh · Condominium · Height and size are disputed: 48 storeys on the developer's homepage and in IPS's portfolio, 49 floors and 190 metres in IPS's topping-out report, but 28 storeys and 162 residential units on the developer's own project page. IPS, which sells the project, reported topping out on 10 March 2026, construction at 95% and handover in 2027; the developer's homepage still says it is set to finish in 2028. Under construction
— Time Square 7 Toul Kork, Phnom Penh · Condominium · 700 units · 49 storeys and 700 residential units per the official project page (Boeung Kak 1, Toul Kork), from a stated $1,000/sqm. IPS (sales agent) says construction launched in 2024 and was at 70% in 2026, with completion expected in 2028. Under construction
— Time Square 8 Toul Tom Pong (Russian Market), Phnom Penh · Condominium · 700 units · 50 storeys and 700 units per the developer and ERA; ERA states completion in Q4 2028 and one-bedrooms from $39,900. IPS (sales agent) says construction launched in April 2025, was at 30% in 2026, and the project was 75% sold. The brand's first tower in the Russian Market (Toul Tom Pong) area. Under construction
— Time Square 10 Otres, Sihanoukville · Condominium · 1300 units · Launched 4 December 2025 from a stated $1,000/sqm; IPS (sales agent) put construction at 15% in 2026. The developer's page describes three connected towers of up to 39 floors with 1,300 residential units on a 5,629 sqm plot. First move outside Phnom Penh; treat as a new-market bet, not an extension of the Phnom Penh record. Under construction
— Time Square 9 (The Gatsby Residence) Street 278, BKK1, Phnom Penh · Condominium · 600 units · Ground broken 8 June 2026 (CIR); IPS said construction was planned to start in July 2026, and we have not confirmed that it has. 39 floors and around 600 units on a 1,765 sqm plot, 1920s Gatsby-inspired Art Deco design, completion targeted around 2029 per the developer; from a stated $1,700/sqm (IPS). Planned
— Time Square 11 (Time Castle XI) Street 113, BKK3, Phnom Penh · Condominium · 390 units · Ground broken 8 June 2026 (CIR). 39 storeys and 390 residential units on Street 113 per the developer. IPS says sales launched on 4 March 2026, construction was expected to start in September 2026 and completion is due in June 2029; we have not confirmed that construction has started. Planned

Profile by Research Cambodia · Added 2026 · Updated 2026. Developer assessments are opinion based on available information at the review date, not statements of fact or financial advice.
